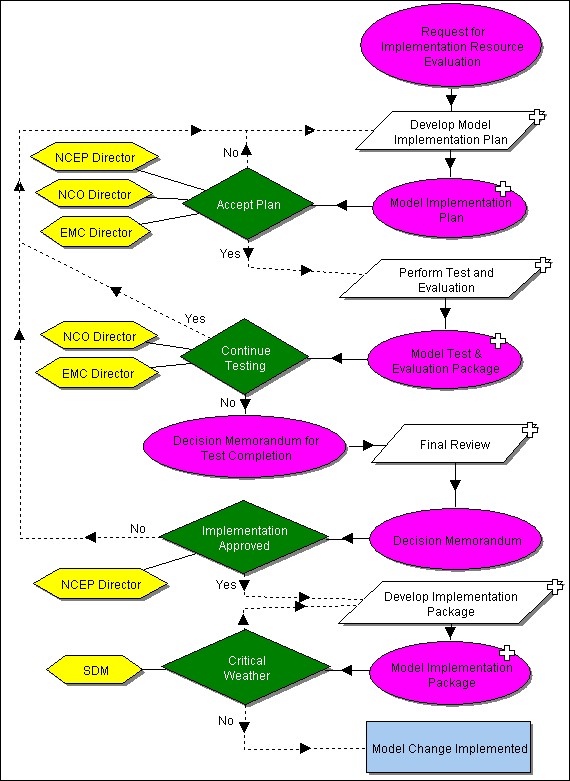

Model Implementation Process
Model Implementation Process
Process Model Summary
Process Model Element
Relationships
Develop Model Implementation Plan
Connections
Conditional Flow
: From -
Accept Plan
Output
: To -
Model Implementation Plan
Input
: From -
Request for Implementation Resource Evaluation
Conditional Flow
: From -
Continue Testing
Conditional Flow
: From -
Implementation Approved
Model Implementation Plan
Connections
Output
: From -
Develop Model Implementation Plan
Input
: To -
Accept Plan
Accept Plan
Connections
Conditional Flow
: To -
Develop Model Implementation Plan
Input
: From -
Model Implementation Plan
Conditional Flow
: To -
Perform Test and Evaluation
Responsibility
: From -
NCO Director
Responsibility
: From -
EMC Director
Responsibility
: From -
NCEP Director
Perform Test and Evaluation
Connections
Conditional Flow
: From -
Accept Plan
Output
: To -
Model Test & Evaluation Package
Model Test & Evaluation Package
Connections
Output
: From -
Perform Test and Evaluation
Input
: To -
Continue Testing
Continue Testing
Connections
Input
: From -
Model Test & Evaluation Package
Output
: To -
Decision Memorandum for Test Completion
Responsibility
: From -
NCO Director
Responsibility
: From -
EMC Director
Conditional Flow
: To -
Develop Model Implementation Plan
Decision Memorandum for Test Completion
Connections
Output
: From -
Continue Testing
Input
: To -
Final Review
Final Review
Connections
Input
: From -
Decision Memorandum for Test Completion
Output
: To -
Decision Memorandum
Develop Implementation Package
Connections
Conditional Flow
: From -
Critical Weather
Output
: To -
Model Implementation Package
Conditional Flow
: From -
Implementation Approved
Model Implementation Package
Connections
Input
: To -
Critical Weather
Output
: From -
Develop Implementation Package
Critical Weather
Connections
Input
: From -
Model Implementation Package
Conditional Flow
: To -
Develop Implementation Package
Conditional Flow
: To -
Model Change Implemented
Responsibility
: From -
SDM
Decision Memorandum
Connections
Output
: From -
Final Review
Input
: To -
Implementation Approved
Model Change Implemented
Connections
Conditional Flow
: From -
Critical Weather
NCO Director
Connections
Responsibility
: To -
Accept Plan
EMC Director
Connections
Responsibility
: To -
Continue Testing
EMC Director
Connections
Responsibility
: To -
Accept Plan
NCO Director
Connections
Responsibility
: To -
Continue Testing
Request for Implementation Resource Evaluation
Connections
Input
: To -
Develop Model Implementation Plan
SDM
Connections
Responsibility
: To -
Critical Weather
Implementation Approved
Connections
Conditional Flow
: To -
Develop Implementation Package
Input
: From -
Decision Memorandum
Responsibility
: From -
NCEP Director
Conditional Flow
: To -
Develop Model Implementation Plan
NCEP Director
Connections
Responsibility
: To -
Implementation Approved
NCEP Director
Connections
Responsibility
: To -
Accept Plan
